Skip to content
HoneyGuide

Home / Help / How to use / Funding readiness

How to use Funding readiness

This guide shows every screen of funding readiness on a phone. The example is a sample spaza shop, Demo Spaza Mmapela (sample). Choose your own answers where the guide gives the example. Part A is funding readiness: the questions a funder asks, your score and your report. Part B is the Funding readiness project plan.

73 steps

Before you start

Have these ready

  • You need a Super Deal Maker account. Sign in first. Do your business plan first: funding readiness reads the amount you need from it.
  • Have these ready if you have them: your CIPC company papers, tax compliance letter (SARS PIN), B-BBEE affidavit, proof of address, lease, trading licence, bank statements and last year's statements.
  • There are 23 screens with about 350 questions. It takes long: do one or two screens at a time. Everything you save stays saved.
  • Market readiness asks the same questions. What you answer here is already there.
  • On every screen: **Save & exit** at the top stops for now. **?** gives help. **Next:** at the bottom takes you to the next screen.
  • Funders on RMK's list are matched to your business. Your score and report show what a funder will ask for, so you can get it ready now.

Step by step

Part A. Start: open your funding readiness

  1. Step 1 of 73

    Open the menu

    On Home, tap Menu.

    Tip: Home's Your next step card, or a row under Continue, may open your funding readiness straight away.

    Screenshot for step 1: Open the menu
  2. Step 2 of 73

    My tools

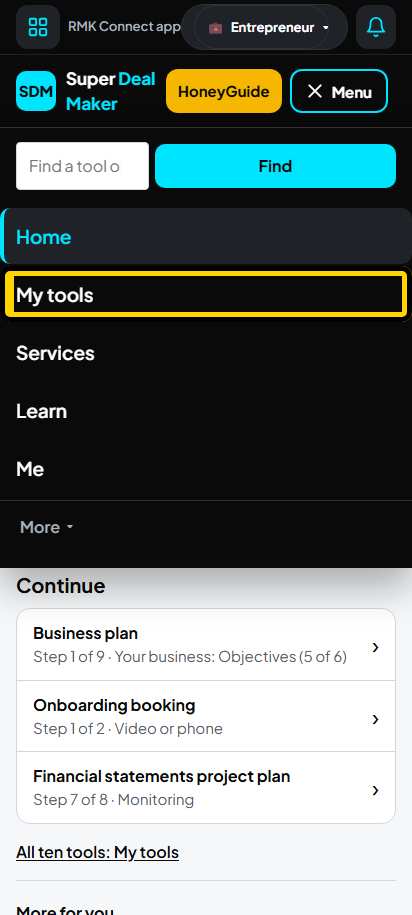

    Tap My tools.

    Screenshot for step 2: My tools

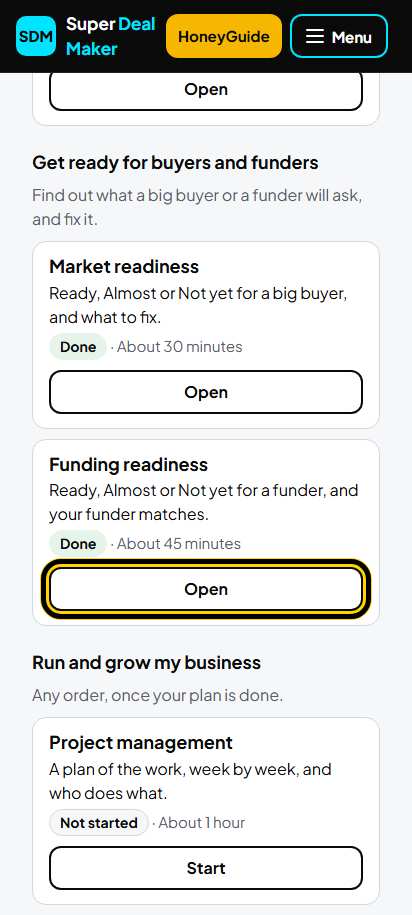

  3. Step 3 of 73

    Funding readiness

    On the Funding readiness card, tap Start.

    Tip: The first time the button says Start, later Continue. When every screen is answered it says Open.

    Screenshot for step 3: Funding readiness
  4. Step 4 of 73

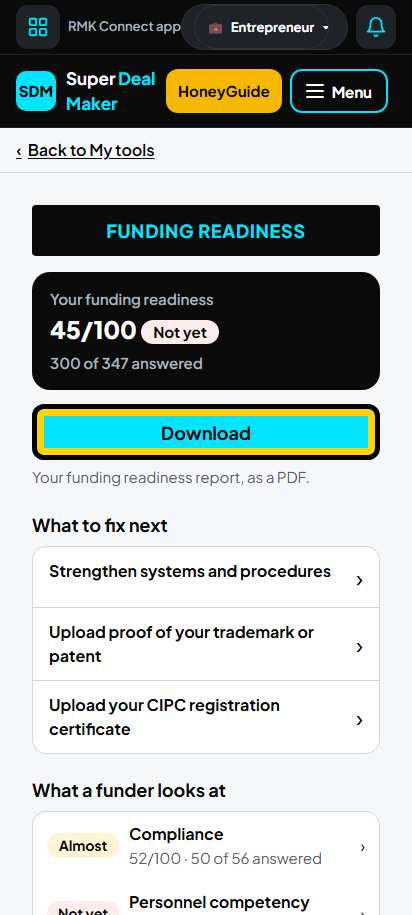

    Your funding readiness page

    At the top is your score, for example "45/100 Not yet", and how many questions you answered. The first time, tap Start the questions. Later the big button says Continue where you left off. When every screen is answered it says Download: your funding readiness report as a PDF.

    Screenshot for step 4: Your funding readiness page

Part A. How each of the 23 screens works

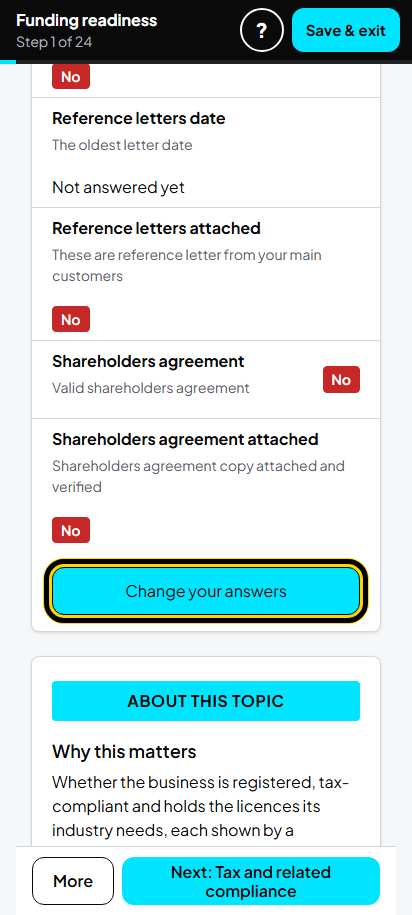

  1. Step 5 of 73

    Your answers

    Each screen first shows your answers and a score. Tap Change your answers (the first time: Answer these questions).

    Tip: The bar at the top says where you are: "Step 1 of 24". There are 23 screens, then your result.

    Screenshot for step 5: Your answers

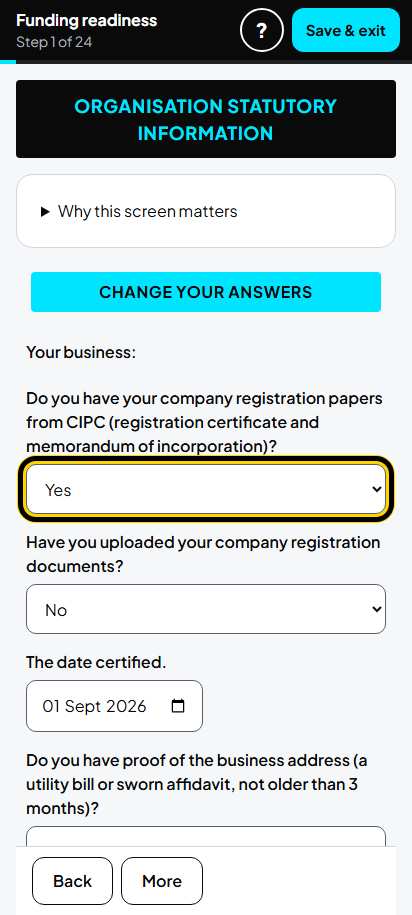

  2. Step 6 of 73

    Choose an answer in each box

    Tap a box and choose. Most questions are Yes, No, Not sure yet or Does not apply to me. Type a date where it asks one. Example, screen 1 (Organisation statutory information): CIPC papers Yes, uploaded No, proof of address Yes, lease Yes until 28 Feb 2027, permit to trade Yes.

    Tip: "Uploaded" means the document is on Super Deal Maker. Say No until you upload it (see Part B).

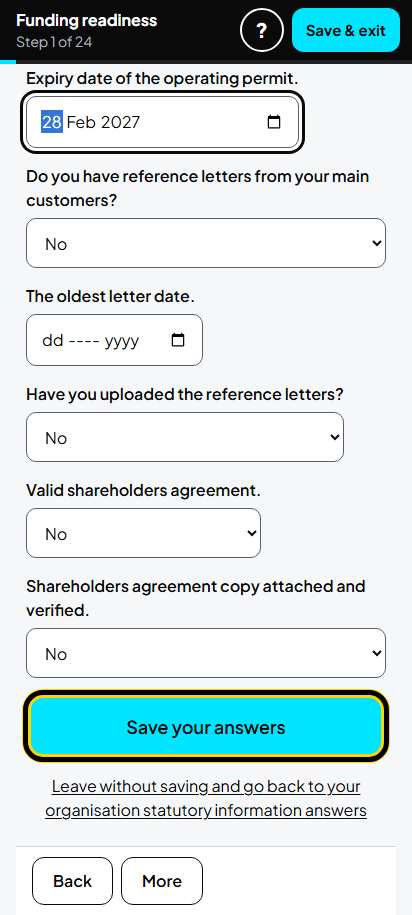

    Screenshot for step 6: Choose an answer in each box
  3. Step 7 of 73

    Save your answers

    Scroll down. Tap Save your answers.

    Screenshot for step 7: Save your answers

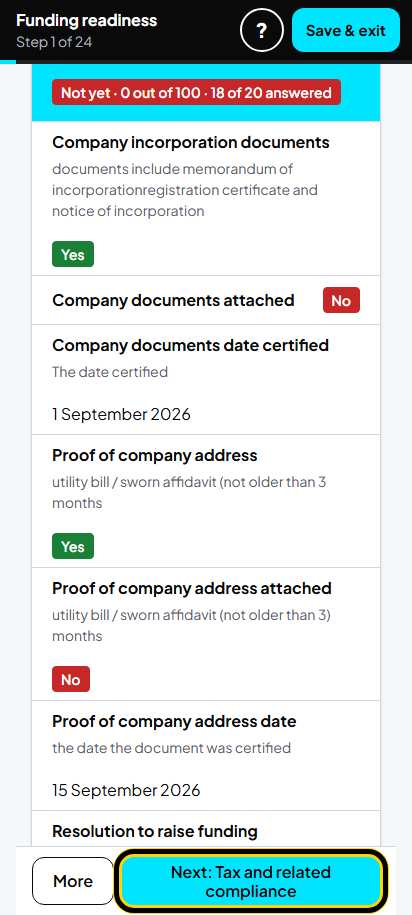

  4. Step 8 of 73

    Go to the next screen

    You see your answers again. Tap Next: at the bottom (here Next: Tax and related compliance). Do the same on every screen.

    Screenshot for step 8: Go to the next screen

Part A, part 1 of 7. Compliance

  1. Step 9 of 73

    Screen 2. Tax and related compliance

    Tax clearance: Yes, and the date it runs out (example 28 Feb 2027). Business bank account and statements: Yes. Not on the government supplier list (CSD): No. B-BBEE affidavit: Yes, until 28 Feb 2027. CIPC annual fees paid: Yes, next due 31 Mar 2027. Tap Save your answers.

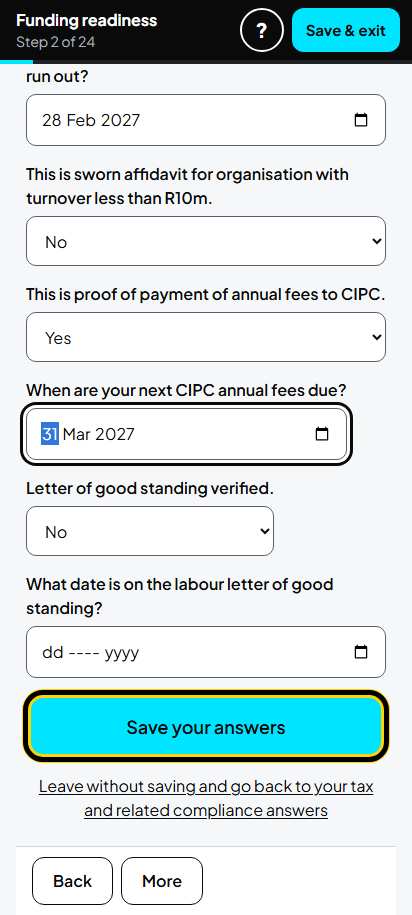

    Screenshot for step 9: Screen 2. Tax and related compliance
  2. Step 10 of 73

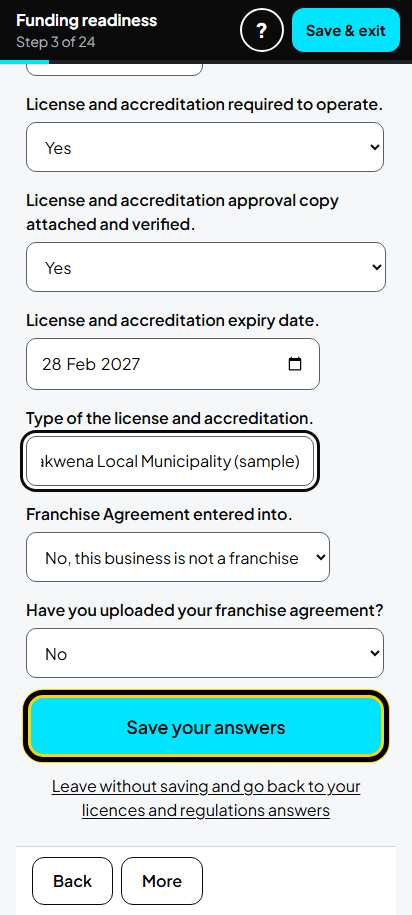

    Screen 3. Licences and regulations

    If your business does not need an environmental, safety (OHS), SABS or food (HACCP) approval, choose No, this business does not need one. Trading licence: Yes, the date it runs out, and its name (example: Trading licence, Mogalakwena Local Municipality). Franchise: No. Tap Save your answers.

    Screenshot for step 10: Screen 3. Licences and regulations

Part A, part 2 of 7. Your people

  1. Step 11 of 73

    Screen 4. Key personnel information

    About the owner: ID copy, proof of address, share certificate: Yes if you have them. Uploaded yet? No until you upload them. Not married in community of property? Then the spouse questions are Does not apply to me. Tap Save your answers.

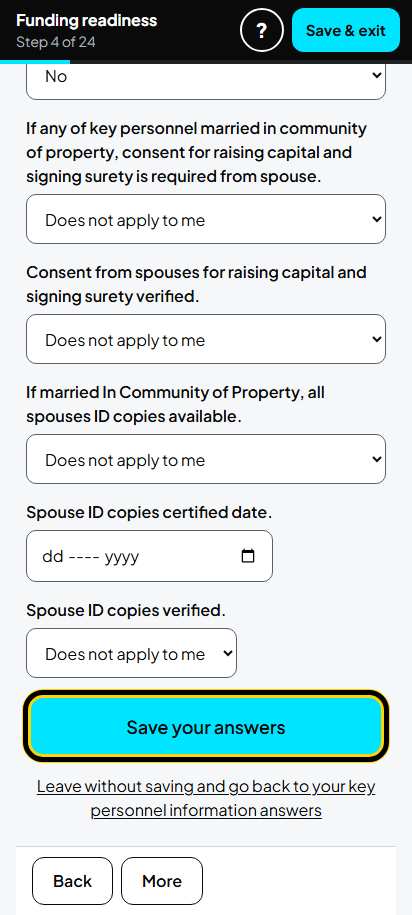

    Screenshot for step 11: Screen 4. Key personnel information
  2. Step 12 of 73

    Screen 5. Team composition

    The owner runs the shop: general manager Yes, Matric, more than 7 years of experience. No separate operations, marketing, money or staff manager: No. Tap Save your answers.

    Tip: A small shop gets a low score here. That is normal: answer honestly.

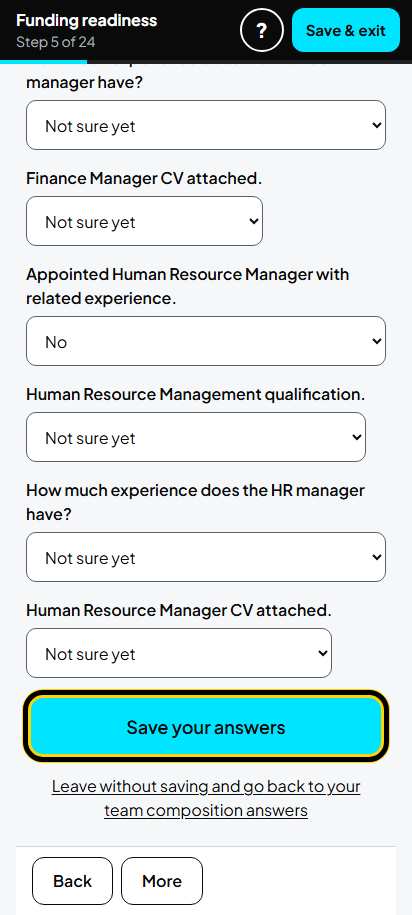

    Screenshot for step 12: Screen 5. Team composition

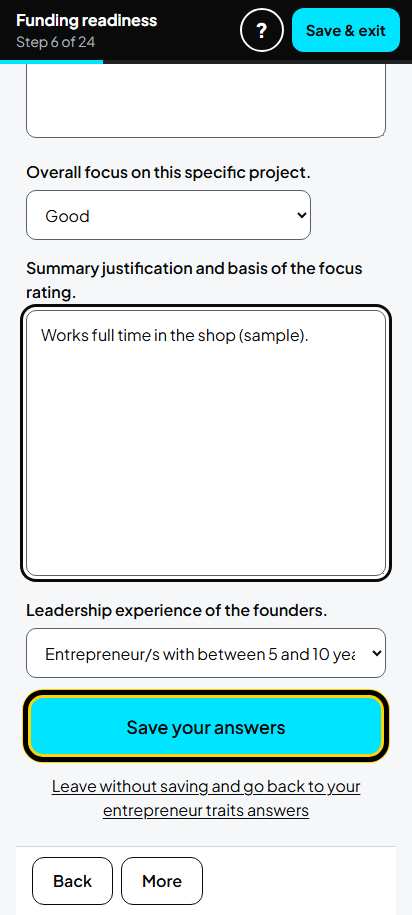

  3. Step 13 of 73

    Screen 6. Entrepreneur traits

    Say how strong you are in each thing (example: vision Averagely, the rest Good). Write one short sentence for each, for example "Started the shop in 2022 with R30 000 of own money". Tap Save your answers.

    Screenshot for step 13: Screen 6. Entrepreneur traits
  4. Step 14 of 73

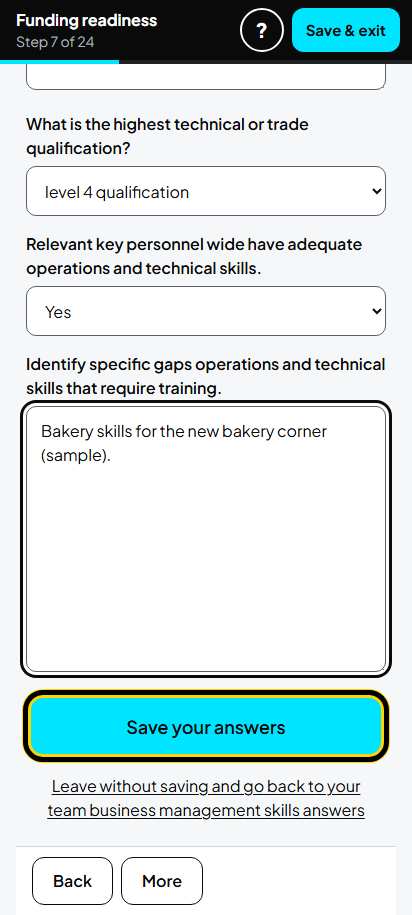

    Screen 7. Team business management skills

    For each skill choose the highest school level in the business (Matric is level 4) and say in a few words what is missing. Tap Save your answers.

    Screenshot for step 14: Screen 7. Team business management skills

Part A, part 3 of 7. Your market

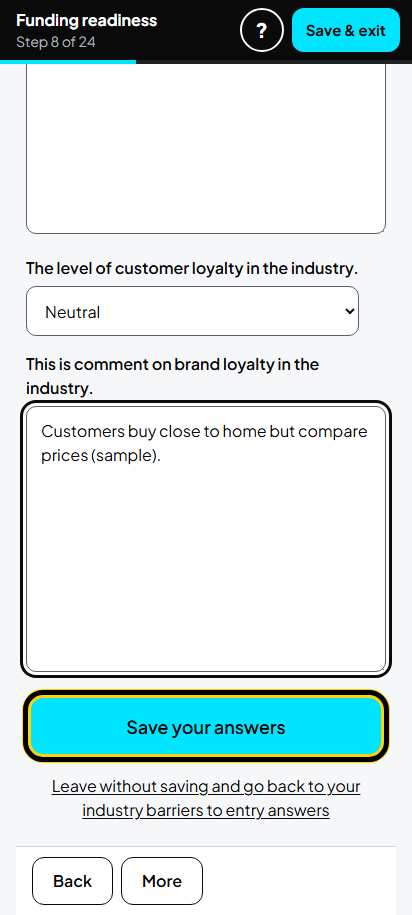

  1. Step 15 of 73

    Screen 8. Industry barriers to entry

    How hard is it for a new shop to start? Example: licence takes less than 6 months, low profits in this trade, customers compare prices (Neutral). Choose the closest answer when yours is not listed. Tap Save your answers.

    Screenshot for step 15: Screen 8. Industry barriers to entry

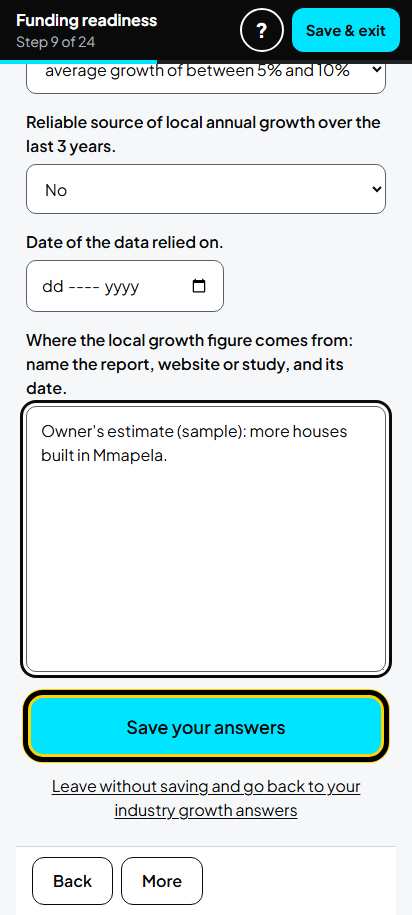

  2. Step 16 of 73

    Screen 9. Industry growth

    How fast does your trade grow? Example: below 5% in the country and the province, 5% to 10% in your village. Proof from a report: No if it is your own estimate; write "Owner's estimate". Tap Save your answers.

    Screenshot for step 16: Screen 9. Industry growth
  3. Step 17 of 73

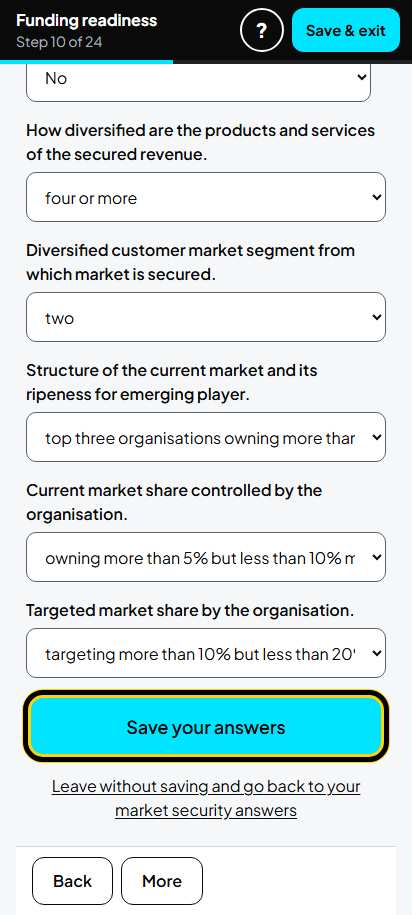

    Screen 10. Market security

    How sure are your sales? Example: more than 50% from customers you already have, four or more customers and products, two kinds of customers (households, school learners), market share 5% to 10% now. Tap Save your answers.

    Screenshot for step 17: Screen 10. Market security

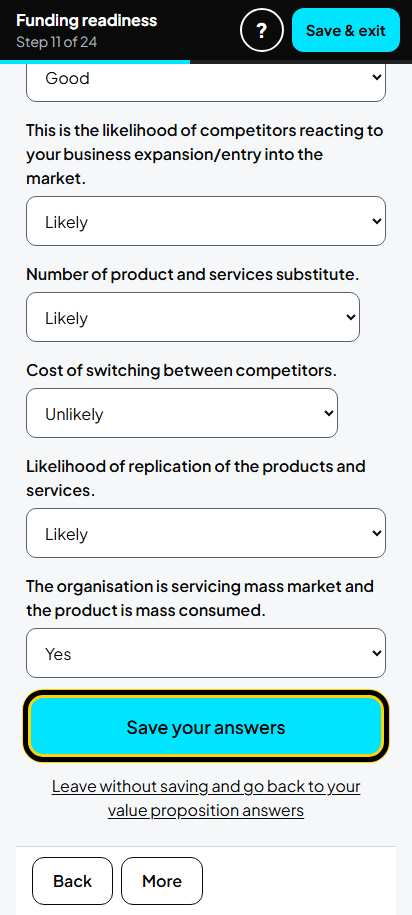

  4. Step 18 of 73

    Screen 11. Value proposition

    Why customers choose you. Example: some uniqueness, quality Good, competitors likely to react. Tap Save your answers.

    Screenshot for step 18: Screen 11. Value proposition

Part A, part 4 of 7. Operations

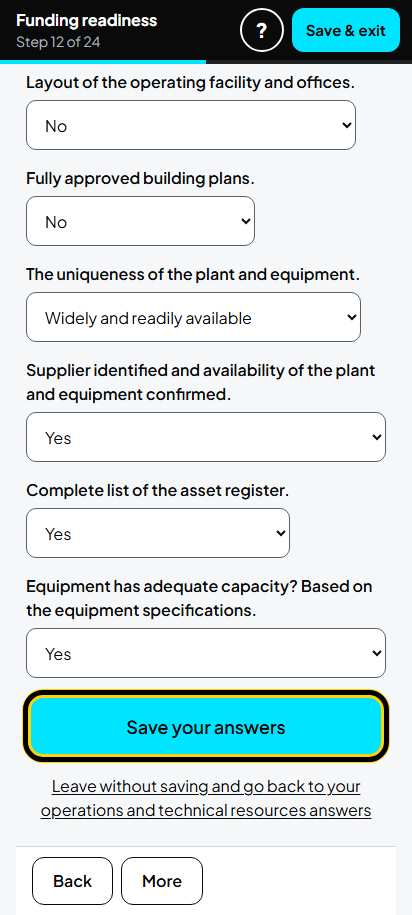

  1. Step 19 of 73

    Screen 12. Operations and technical resources

    Stock easy to get (within 5 working days), the room is secured with a lease, equipment easy to buy, you keep a list of what you own: Yes. Tap Save your answers.

    Screenshot for step 19: Screen 12. Operations and technical resources
  2. Step 20 of 73

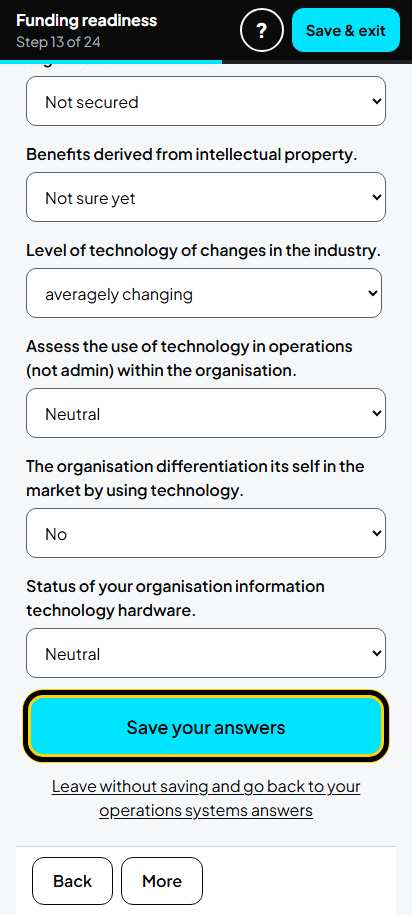

    Screen 13. Operations systems

    How you work. A shop: batch process, no special skill needed, gross profit below 40%, one shift, no trademark or patent. Tap Save your answers.

    Screenshot for step 20: Screen 13. Operations systems

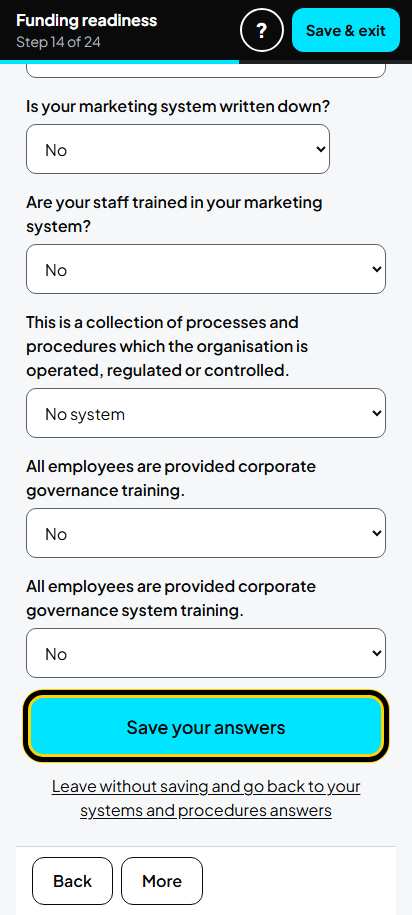

  3. Step 21 of 73

    Screen 14. Systems and procedures

    Are your ways of working written down? Example: stock and money "insufficiently documented"; staff, marketing and governance "No system". Tap Save your answers.

    Screenshot for step 21: Screen 14. Systems and procedures

Part A, part 5 of 7. The money

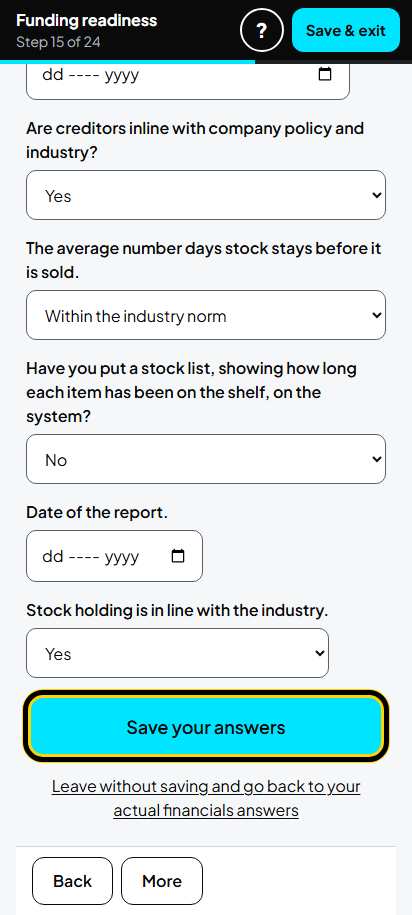

  1. Step 22 of 73

    Screen 15. Actual financials

    Signed statements: No if nobody signed them yet; year end 28 Feb 2026; profitable Yes. Management accounts Yes (30 Sep 2026). Customers pay cash and you pay cash: choose "two times better". Tap Save your answers.

    Screenshot for step 22: Screen 15. Actual financials

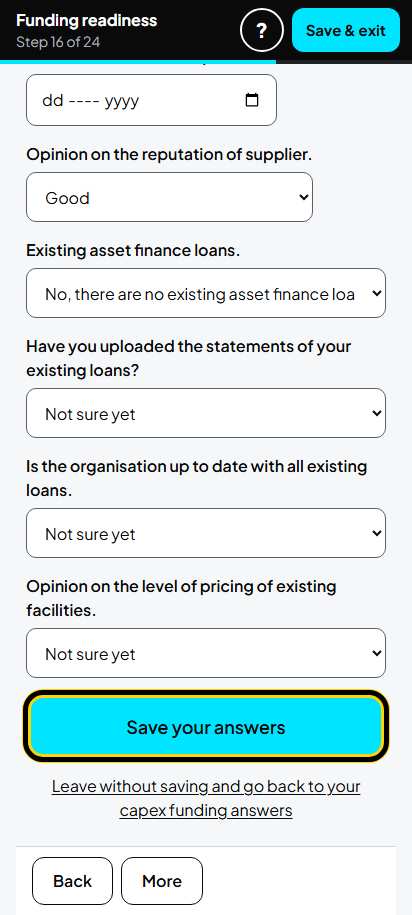

  2. Step 23 of 73

    Screen 16. Capex funding

    Money for equipment. The amount comes from your business plan (R60 000). Can the equipment be security? Yes. Quotes: No quotes yet until you have 3 quotes. No existing loans. Tap Save your answers.

    Screenshot for step 23: Screen 16. Capex funding

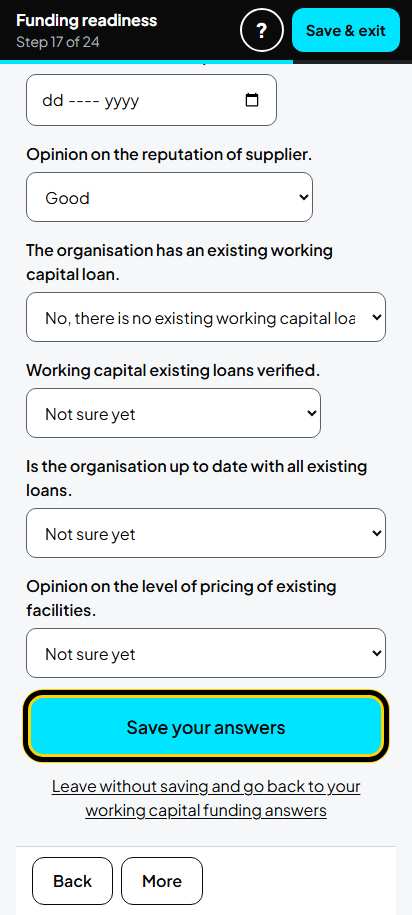

  3. Step 24 of 73

    Screen 17. Working capital funding

    Money for stock and running costs. The amount comes from your business plan (R25 000). Answer like the screen before. Tap Save your answers.

    Screenshot for step 24: Screen 17. Working capital funding

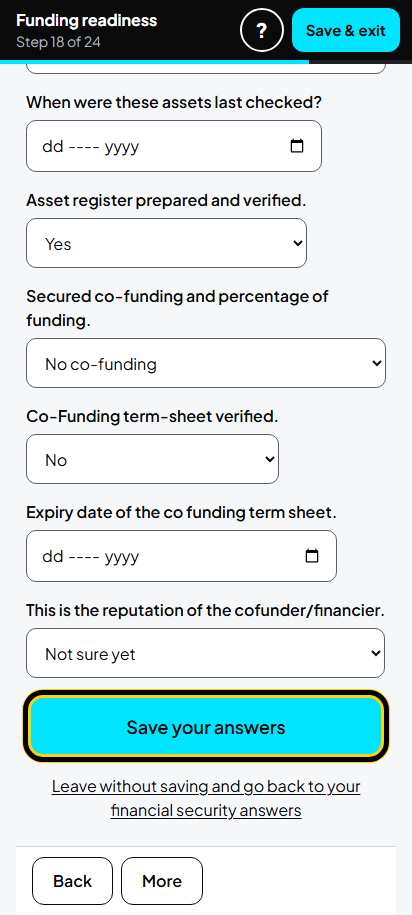

  4. Step 25 of 73

    Screen 18. Financial security

    Will the owner sign surety? Yes (not unlimited). What you own that is free of loans: 0% to 20% of what you ask. No other funder yet: "No co-funding". Tap Save your answers.

    Screenshot for step 25: Screen 18. Financial security
  5. Step 26 of 73

    Screen 19. Financial projections

    Compare your plan with the past. Example: sales 110% to 150% of before, net profit 5% to 10%, gross profit 20% to 50%. Tap Save your answers.

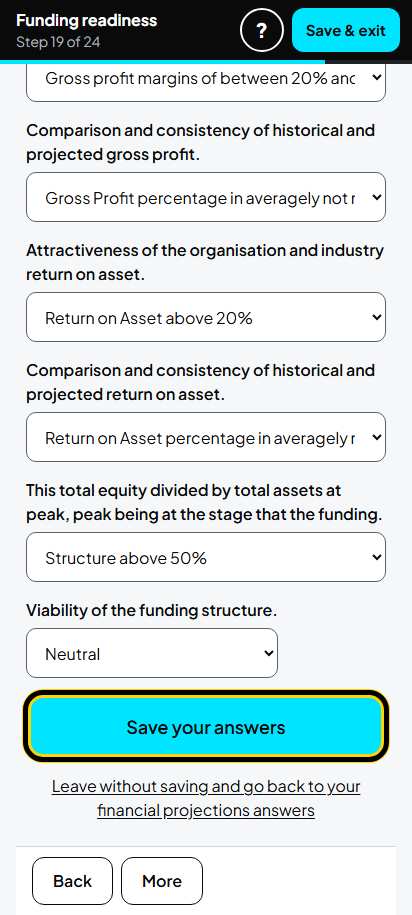

    Screenshot for step 26: Screen 19. Financial projections

  6. Step 27 of 73

    Screen 20. Key personnel tax and personal finances

    About the owner's own money: personal tax clearance No, 6 months of bank statements Yes, a list of income and costs Yes, no credit check yet, not in public office, no bad news stories. Tap Save your answers.

    Screenshot for step 27: Screen 20. Key personnel tax and personal finances

Part A, part 6 of 7. Legal claims

  1. Step 28 of 73

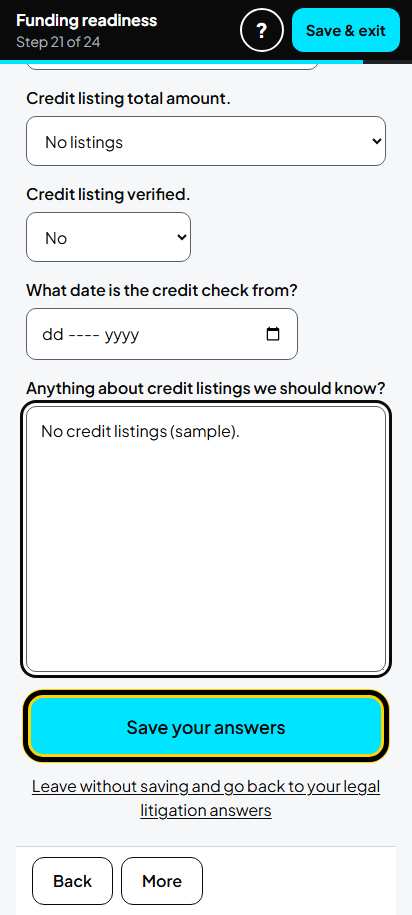

    Screen 21. Legal litigation

    No court cases and no credit listings: choose No and "No litigation" / "No listings". Tap Save your answers.

    Screenshot for step 28: Screen 21. Legal litigation

Part A, part 7 of 7. B-BBEE and jobs

  1. Step 29 of 73

    Screen 22. Social empowerment

    Small business (EME). Black, women and youth ownership: 51% or more. Women and youth in leadership: Yes. Tap Save your answers.

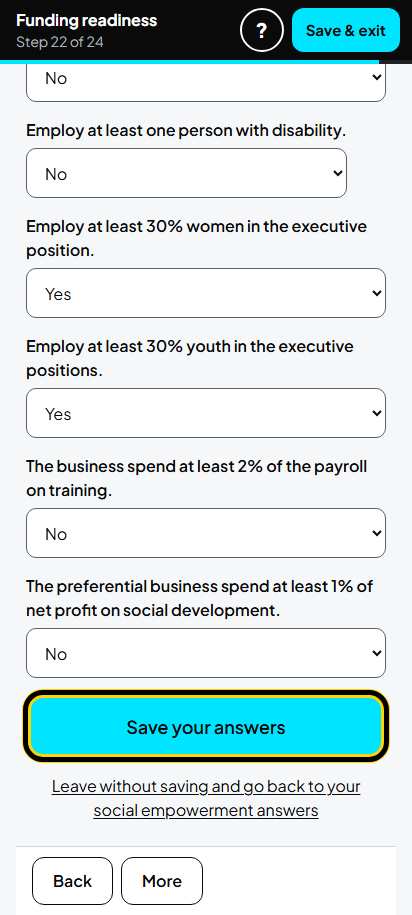

    Screenshot for step 29: Screen 22. Social empowerment
  2. Step 30 of 73

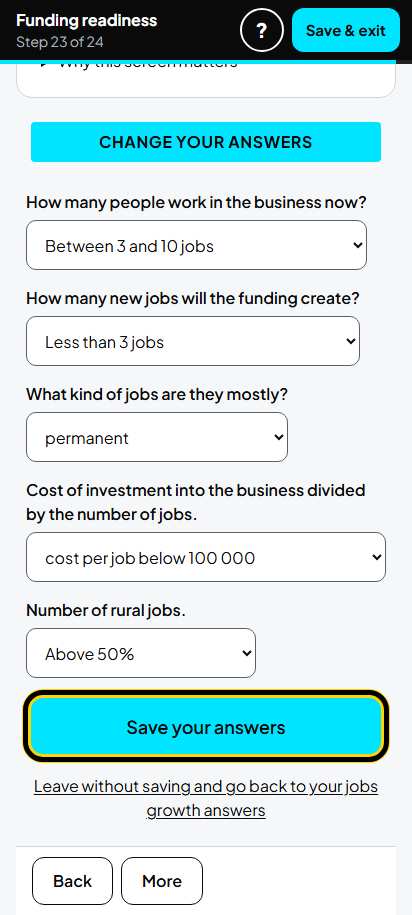

    Screen 23. Jobs growth

    Jobs now: between 3 and 10. New jobs: fewer than 3. Permanent jobs, cost per job below R100 000, more than 50% rural. Tap Save your answers.

    Screenshot for step 30: Screen 23. Jobs growth

Part A. Your result

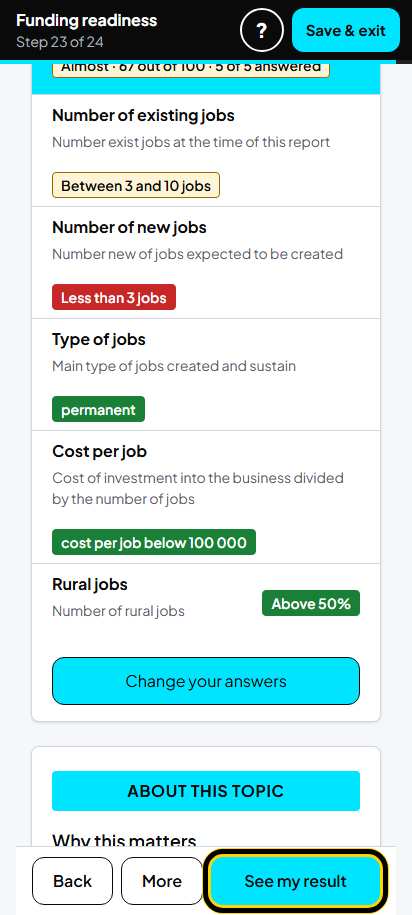

  1. Step 31 of 73

    See my result

    On the last screen (Jobs growth), tap See my result.

    Screenshot for step 31: See my result

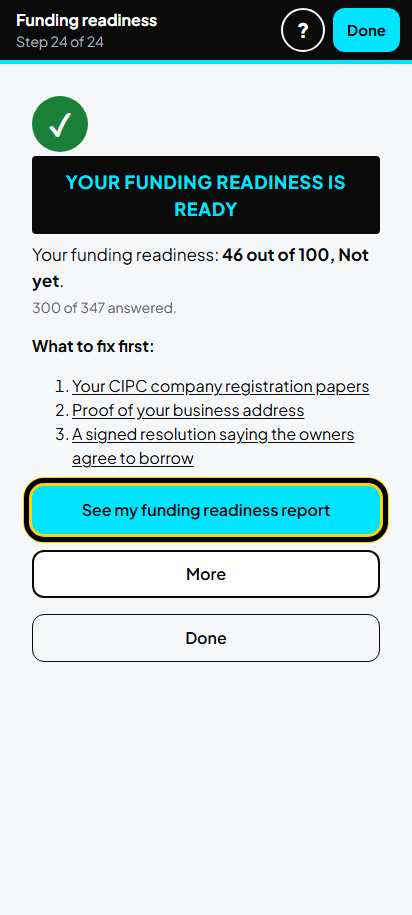

  2. Step 32 of 73

    Your funding readiness is ready

    You see your score and the 3 things to fix first. Tap a thing to fix it. Tap See my funding readiness report to read the whole report.

    Screenshot for step 32: Your funding readiness is ready

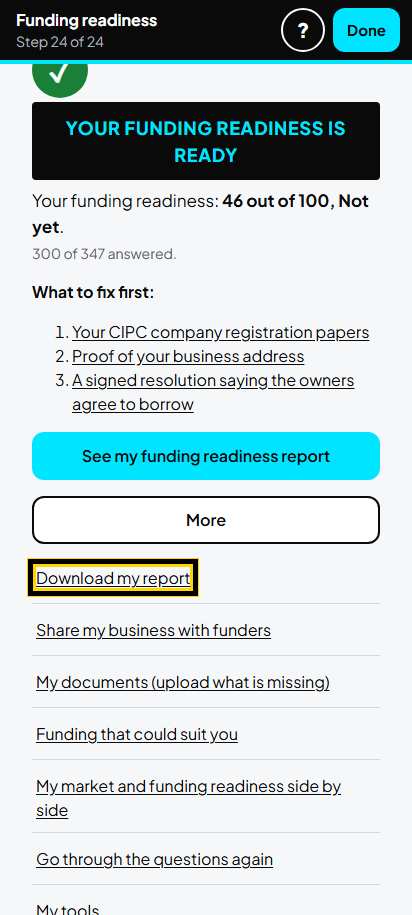

  3. Step 33 of 73

    More

    Tap More for: Download my report, Share my business with funders, My documents, Funding that could suit you, side by side, Go through the questions again.

    Screenshot for step 33: More

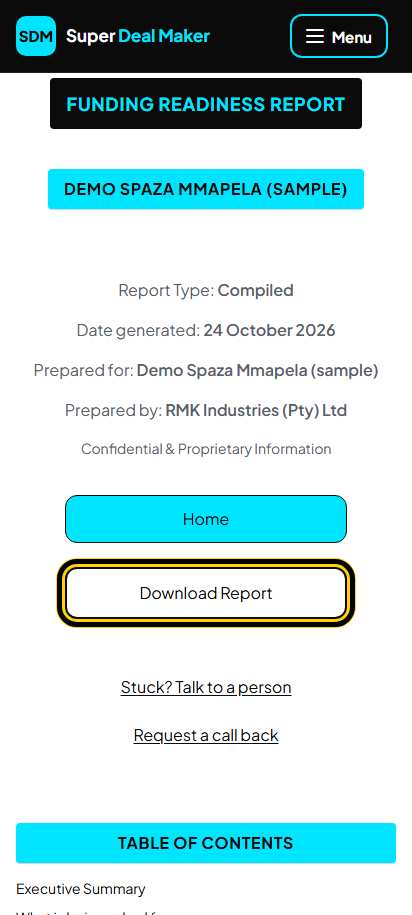

  4. Step 34 of 73

    Your report on screen

    The report shows the 7 parts a funder looks at, what is missing and what to do. Tap Download Report to save the PDF on your phone.

    Screenshot for step 34: Your report on screen

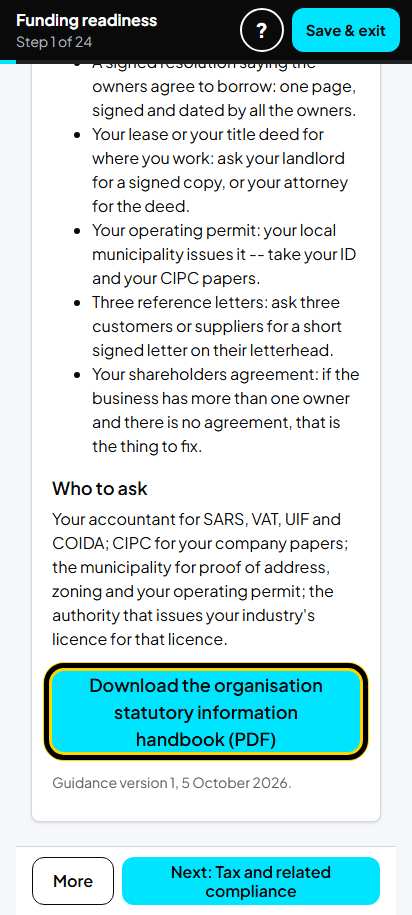

  5. Step 35 of 73

    A guide for each screen

    Each of the 23 screens has a short guide that explains its questions. Scroll down on the screen and tap Download the ... handbook (PDF).

    Tip: The guide explains the questions. It does not hold your answers.

    Screenshot for step 35: A guide for each screen

Part A. More on your funding readiness page

  1. Step 36 of 73

    What a funder will ask you

    On your funding readiness page tap More, then The full page with every control. Under Your money side, tap What a funder will ask you that your business plan does not hold.

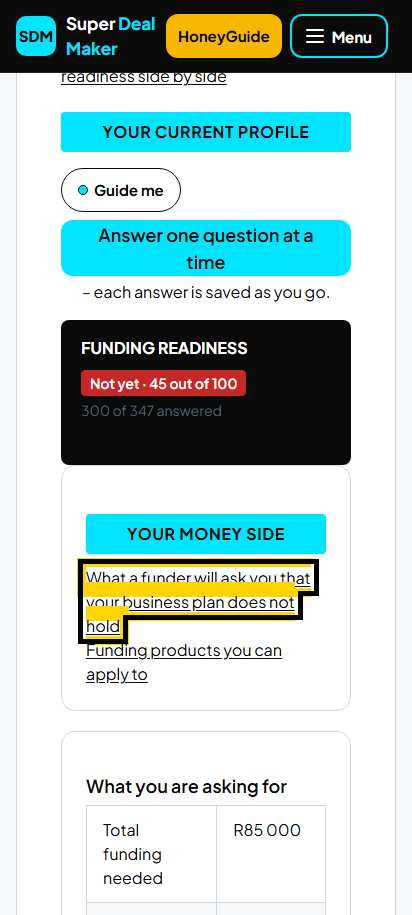

    Screenshot for step 36: What a funder will ask you
  2. Step 37 of 73

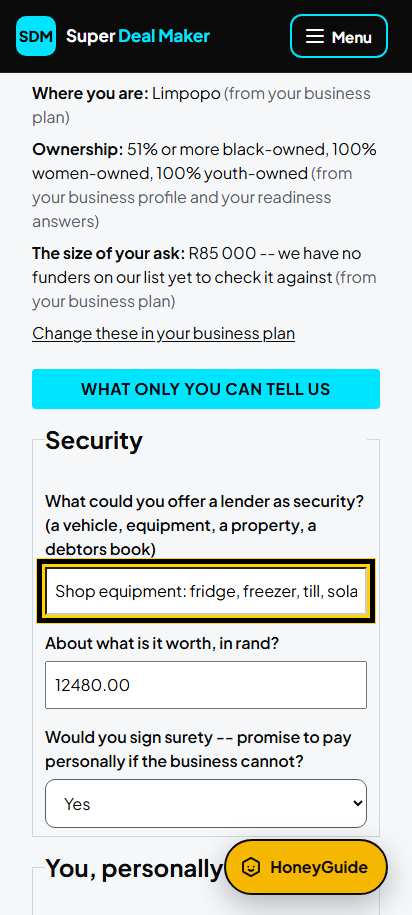

    Security and your own money

    What we already know comes from your business plan. Below it, type what you could offer as security (example: shop equipment, worth 12480), whether you would sign surety, what you own and owe, and what comes in and goes out each month.

    Screenshot for step 37: Security and your own money

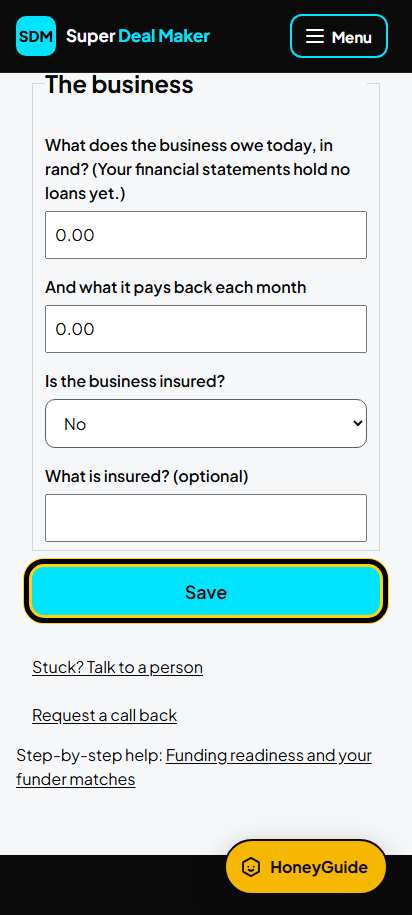

  3. Step 38 of 73

    Save

    Say what the business owes and whether it is insured. Tap Save. It says "Saved". This does not change your score: a funder reads it beside your score.

    Screenshot for step 38: Save
  4. Step 39 of 73

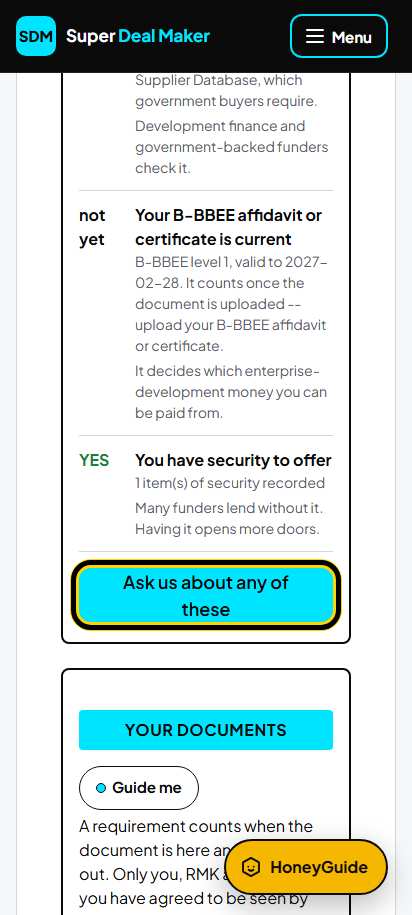

    What a funder asks for

    On the same full page, this list shows what funders usually ask for, with YES or not yet. Tap Ask us about any of these if you need help.

    Screenshot for step 39: What a funder asks for
  5. Step 40 of 73

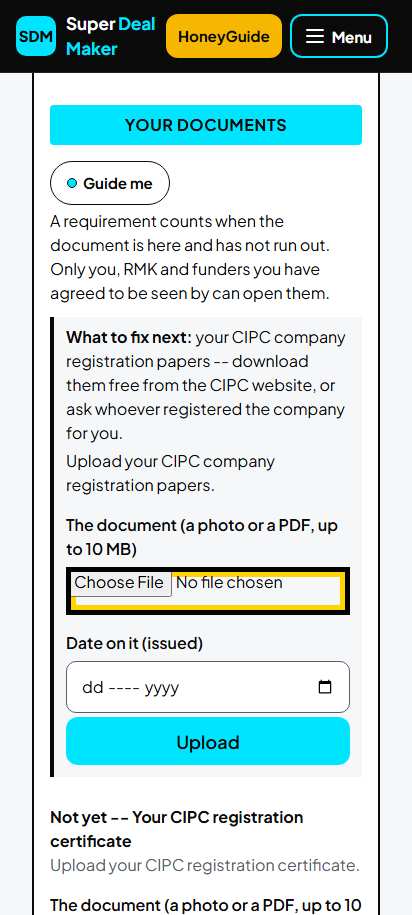

    Upload a document

    On your funding readiness page tap More. Under Your documents, tap Choose File and pick the photo or PDF. Type the date on it and the date it runs out. Tap Upload. It then says "On file".

    Tip: A document counts only when it is uploaded and not out of date. Example: the tax compliance letter, valid to 28 February 2027.

    Screenshot for step 40: Upload a document
  6. Step 41 of 73

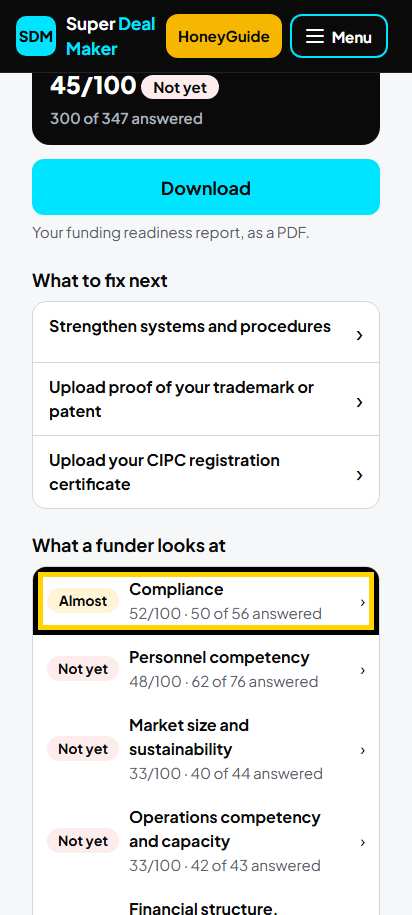

    What a funder looks at

    Lower on the page, What a funder looks at shows the 7 areas. Each has a score, Ready, Almost or Not yet, and how many questions are answered. Tap an area to check or change its screens.
    What to fix next above it lists the 3 things that would lift your score most: tap one to fix it.

    Screenshot for step 41: What a funder looks at
  7. Step 42 of 73

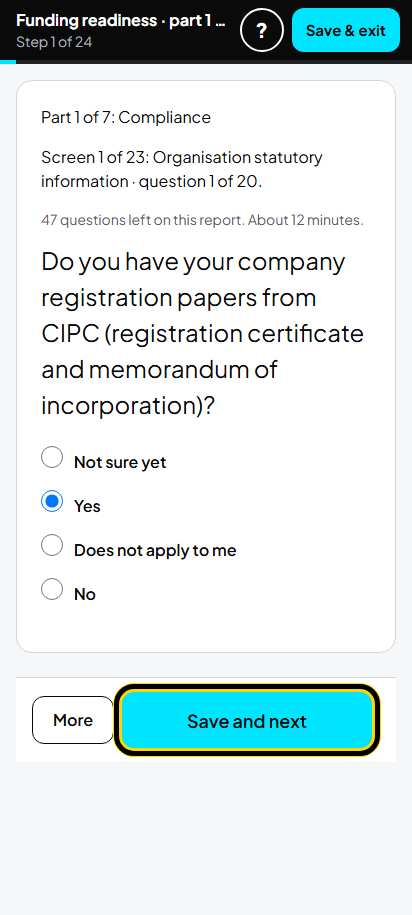

    One question at a time

    On your funding readiness page you can also tap More, then Answer one question at a time. Choose your answer and tap Save and next.

    Tip: It shows how many questions are left and about how many minutes.

    Screenshot for step 42: One question at a time
  8. Step 43 of 73

    Market and funding side by side

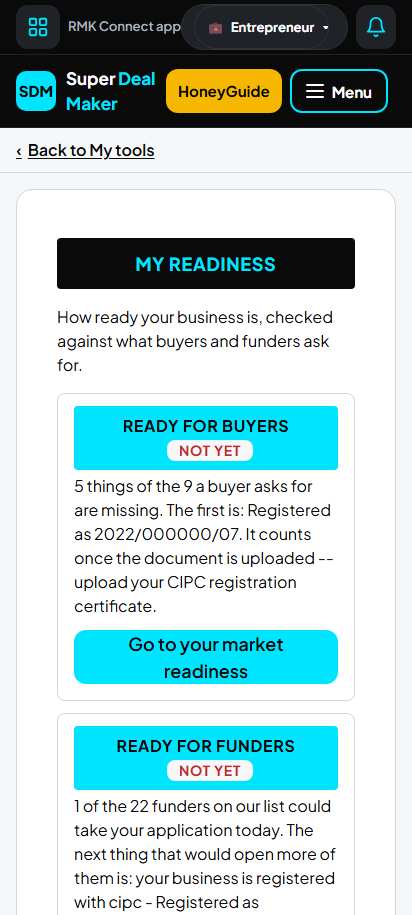

    More, then My market and funding readiness side by side shows both. Market and funding readiness share the same questions: answer once.

    Screenshot for step 43: Market and funding side by side
  9. Step 44 of 73

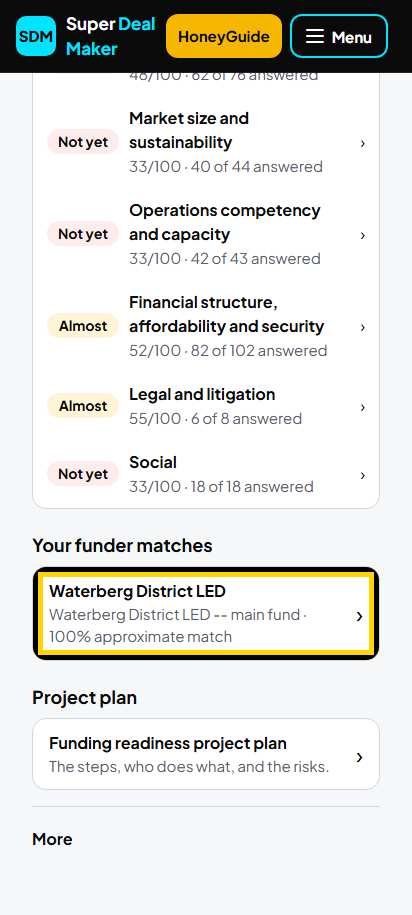

    Your funder matches

    Under Your funder matches are the funding products that fit your business, with how well they match. Tap one to see all the funding products you can apply to, and what would open the others.

    Tip: A match is worked out by the platform from your plan and your answers. It is not a funder's decision: every funder decides for itself.

    Screenshot for step 44: Your funder matches
  10. Step 45 of 73

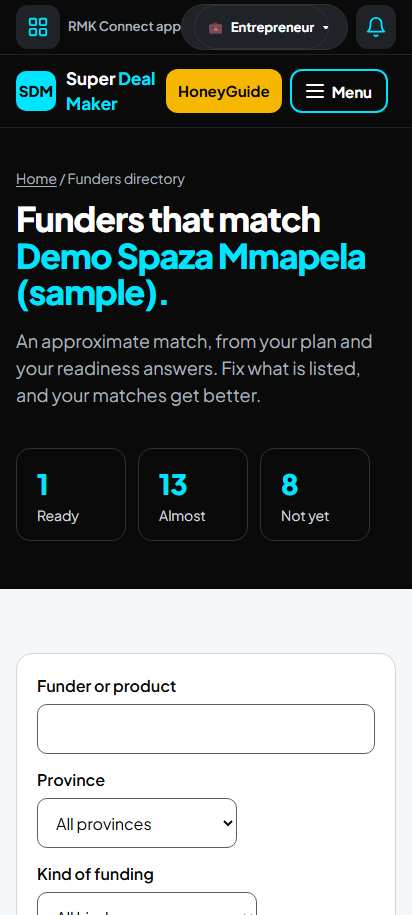

    Find funders

    Tap Menu, More, then Funders directory: the funders that match your business, with how many are Ready, Almost or Not yet for you.

    Screenshot for step 45: Find funders

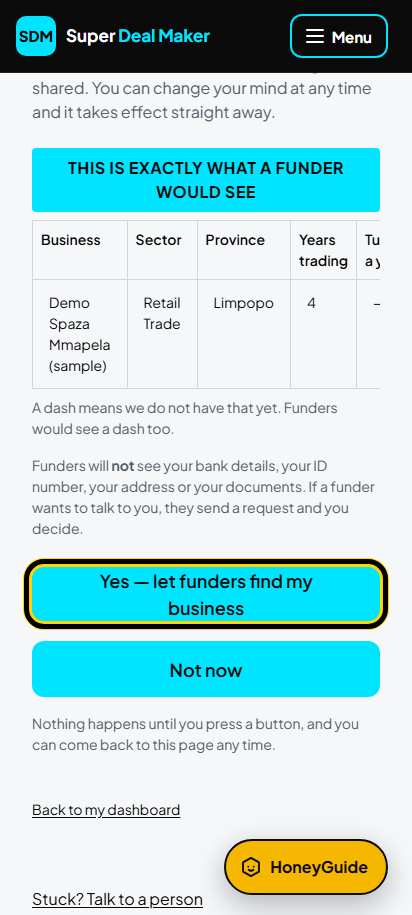

  11. Step 46 of 73

    Let funders find your business

    "Share my business with funders" (under More on your result) shows exactly the one row a funder would see. Tap Yes – let funders find my business only if you want that. Not now keeps you hidden. You can change your mind any time.

    Tip: Funders never see your bank details, ID number, address or documents. This is part of Standard.

    Screenshot for step 46: Let funders find your business

Part B. Funding readiness project plan

  1. Step 47 of 73

    Open the project plan

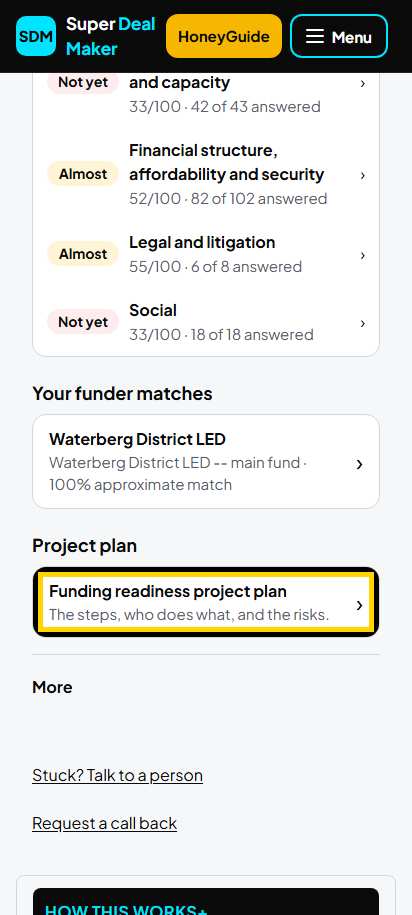

    On your funding readiness page, under Project plan, tap Funding readiness project plan. The first time it is under More: tap Start your funding readiness project plan. Your project is made with example rows.

    Screenshot for step 47: Open the project plan

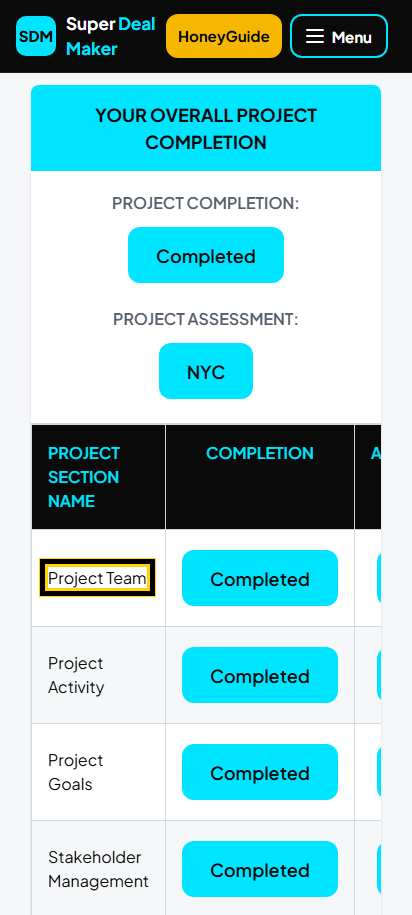

  2. Step 48 of 73

    Your project home

    The project has 7 parts: Project Team, Project Activity, Project Goals, Stakeholder Management, Project Resources, Project Risk, Project Monitoring. Tap a part to open it.

    Tip: The example rows are for a big company ("Secure R2 million"). Change them to your own, or delete them.

    Screenshot for step 48: Your project home
  3. Step 49 of 73

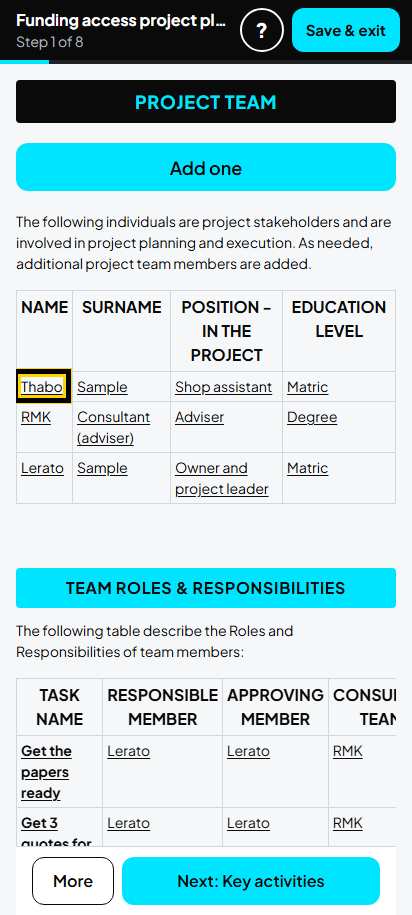

    1. Project team: the list

    Tap a name to edit it. Tap Add one to add a person. Delete example people you do not have.

    Screenshot for step 49: 1. Project team: the list
  4. Step 50 of 73

    1. Project team: one person

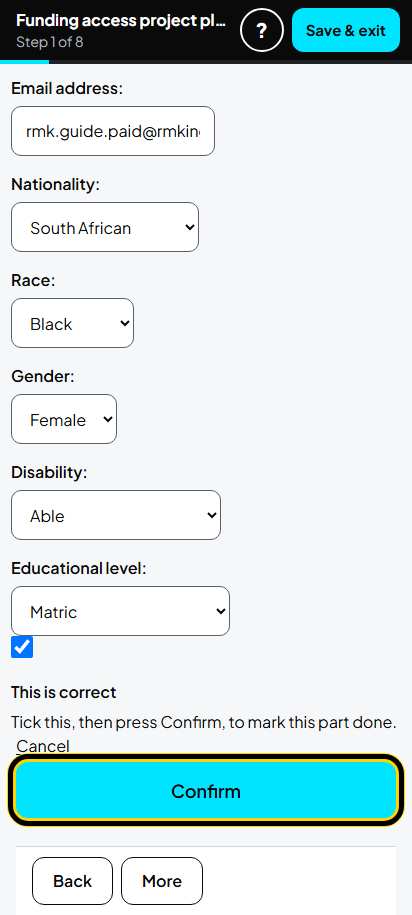

    Type the name, the position in the project and the education. Example: Lerato Sample, Owner and project leader, Matric. Tick This is correct. Tap Confirm.

    Screenshot for step 50: 1. Project team: one person
  5. Step 51 of 73

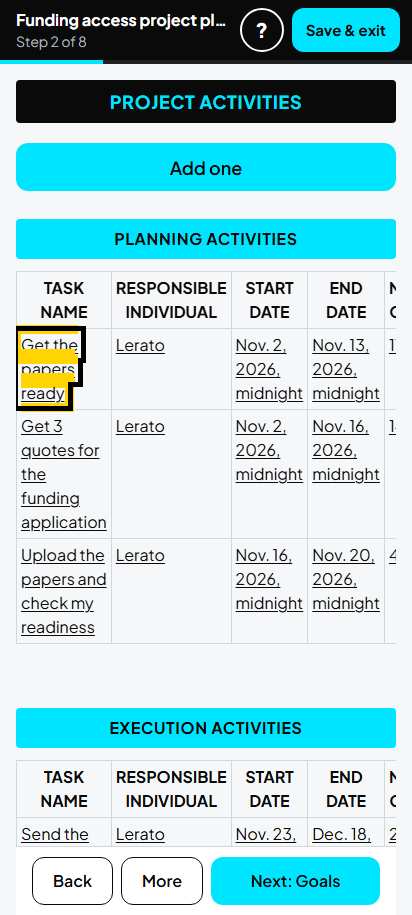

    2. Project activities: the list

    Tap a task to edit it. Tap Add one for a new task.

    Screenshot for step 51: 2. Project activities: the list
  6. Step 52 of 73

    2. Project activities: one task

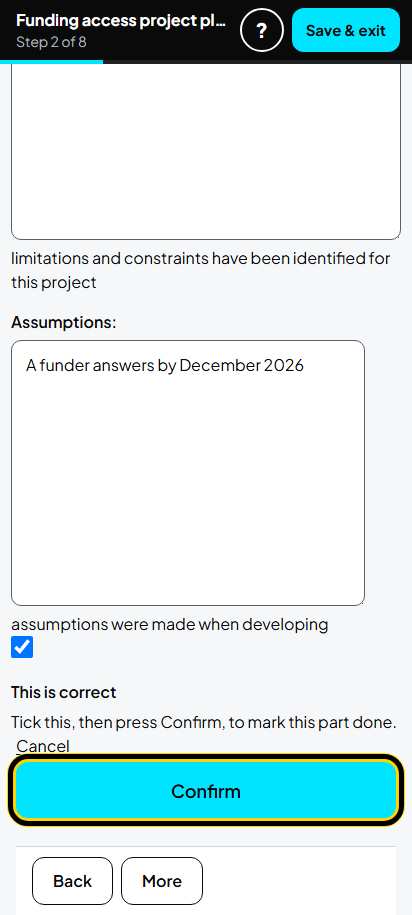

    Type the task, what it is for, the start and end dates, and who does it. Example: Get the papers ready (CIPC papers, B-BBEE affidavit, proof of address), 2 to 13 Nov 2026, Lerato. Tick This is correct. Tap Confirm.

    Tip: The stage (Planning, Execution, Feedback) cannot be changed on an example task. Edit an example task of the right stage, or tap Add one.

    Screenshot for step 52: 2. Project activities: one task
  7. Step 53 of 73

    3. Project goals: the list

    Tap Edit on each goal. Tap Add one for a new goal.

    Screenshot for step 53: 3. Project goals: the list

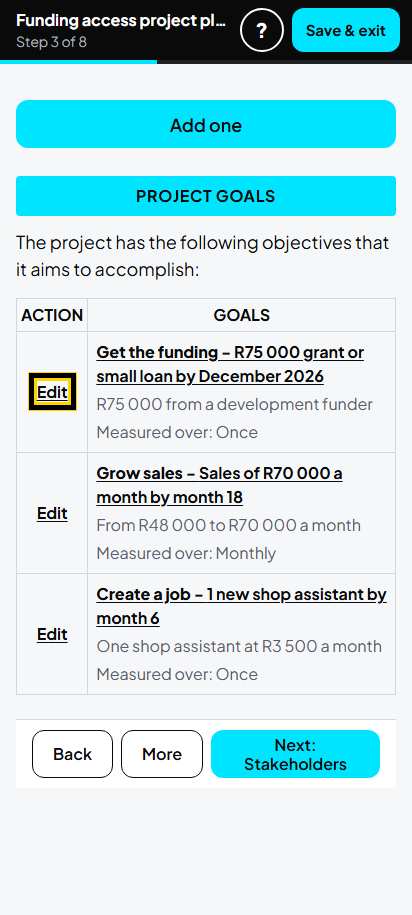

  8. Step 54 of 73

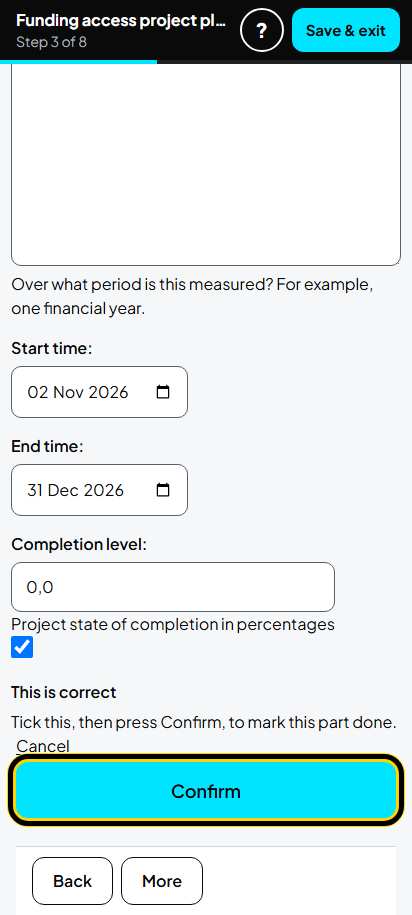

    3. Project goals: one goal

    Type the goal and how you will measure it. Example: Get the funding, R75 000 by December 2026. Tick This is correct. Tap Confirm.

    Screenshot for step 54: 3. Project goals: one goal

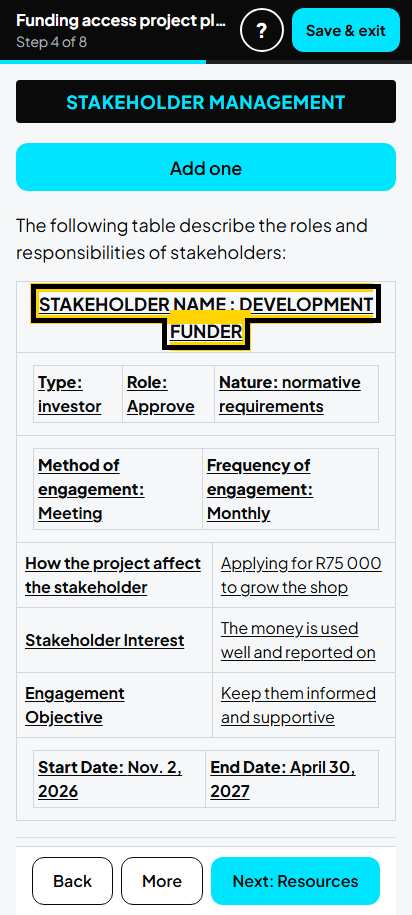

  9. Step 55 of 73

    4. Stakeholders: the list

    Tap a name to edit it. Tap Add one to add one. Example: the funder, customers, the landlord, the wholesaler, the ward councillor.

    Screenshot for step 55: 4. Stakeholders: the list
  10. Step 56 of 73

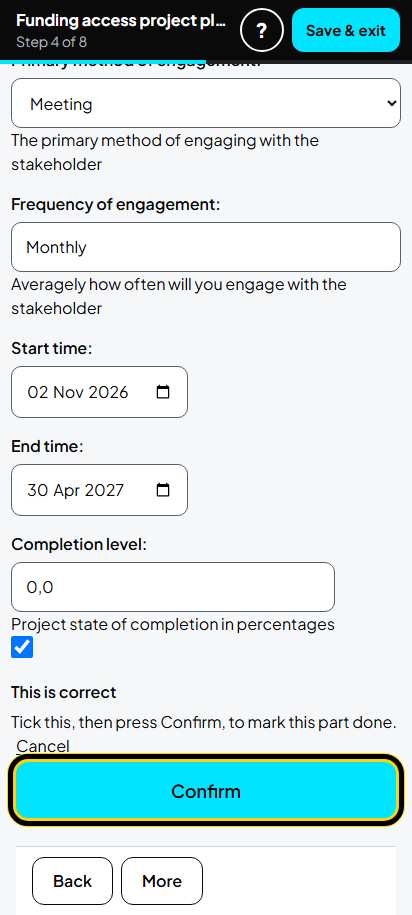

    4. Stakeholders: one stakeholder

    Type the name, choose the type and role, say what they want and how often you meet. Tick This is correct. Tap Confirm.

    Screenshot for step 56: 4. Stakeholders: one stakeholder
  11. Step 57 of 73

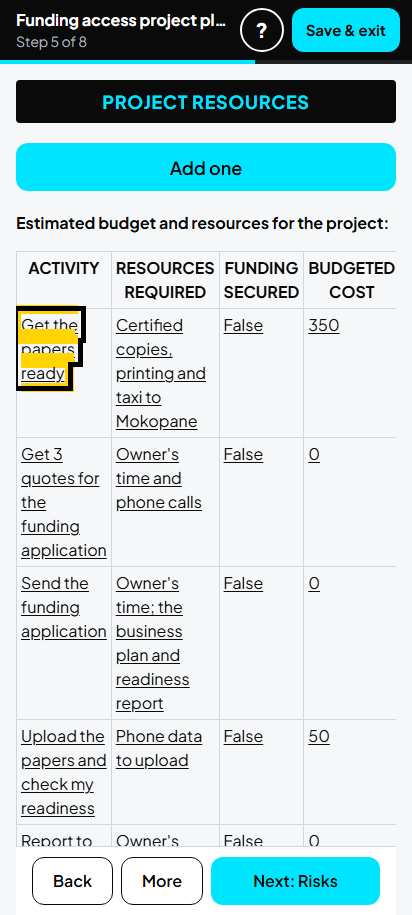

    5. Project resources: the list

    One row for each task. Tap the task to edit it.

    Screenshot for step 57: 5. Project resources: the list
  12. Step 58 of 73

    5. Project resources: one row

    Type what the task needs and what it costs. Example: Get the papers ready, certified copies, printing and taxi, 350. Tick This is correct. Tap Confirm.

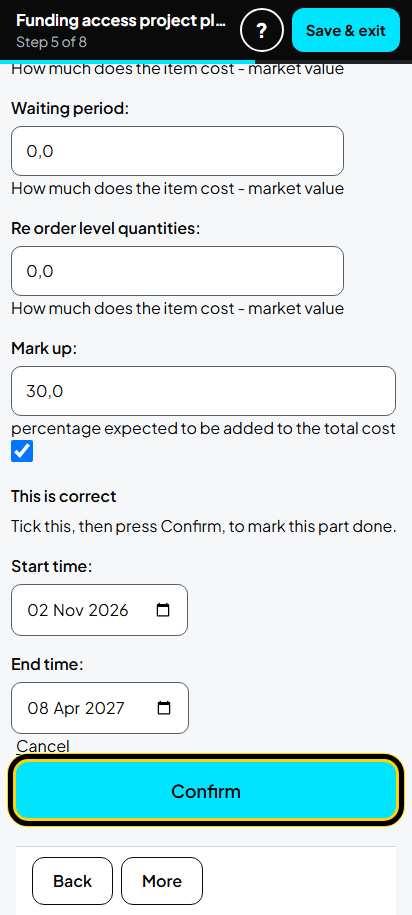

    Screenshot for step 58: 5. Project resources: one row
  13. Step 59 of 73

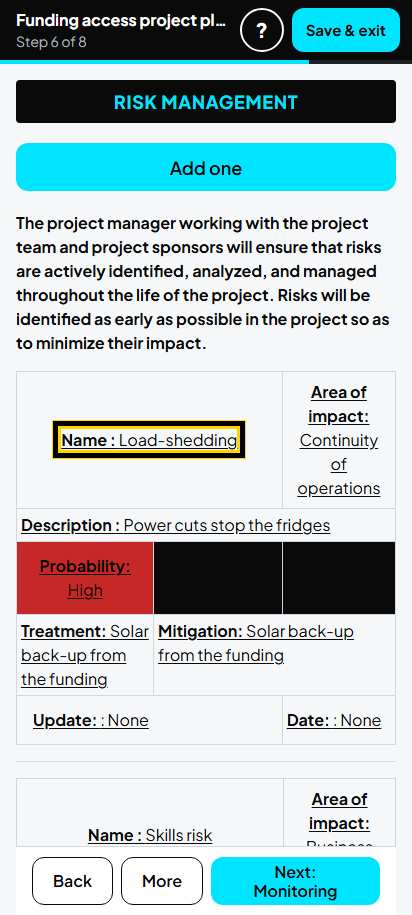

    6. Project risks: the list

    Tap a risk name to edit it. Tap Add one for a new risk.

    Screenshot for step 59: 6. Project risks: the list
  14. Step 60 of 73

    6. Project risks: one risk

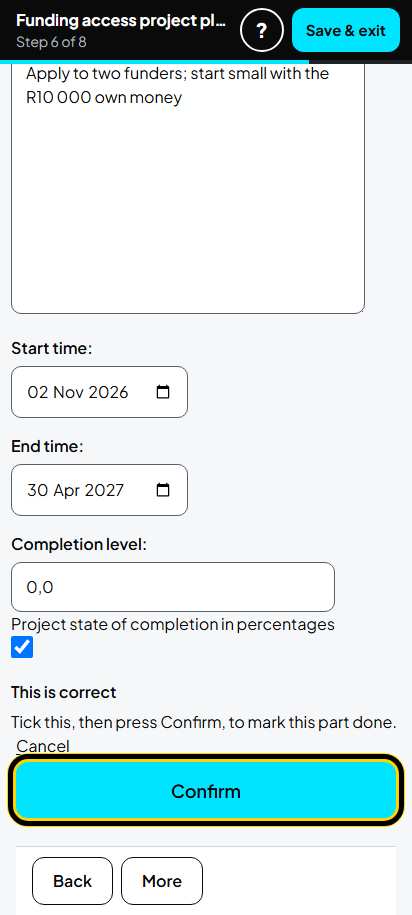

    Type the risk and what you will do about it. Example: Funding not approved, apply to two funders. Choose every box: area, impact, likelihood, ranking and action. Tick This is correct. Tap Confirm.

    Tip: If you leave a box empty, the page shows an error. Choose every box, then tap Confirm again.

    Screenshot for step 60: 6. Project risks: one risk
  15. Step 61 of 73

    7. Monitoring: the list

    One row for each task. Tap the task to edit it.

    Screenshot for step 61: 7. Monitoring: the list

  16. Step 62 of 73

    7. Monitoring: one row

    Say how you check the task. Example: meeting, a weekly check every Sunday and a monthly review with the consultant. Tick This is correct. Tap Confirm.

    Screenshot for step 62: 7. Monitoring: one row
  17. Step 63 of 73

    Finish my project plan

    On the Monitoring list, tap Finish my project plan.

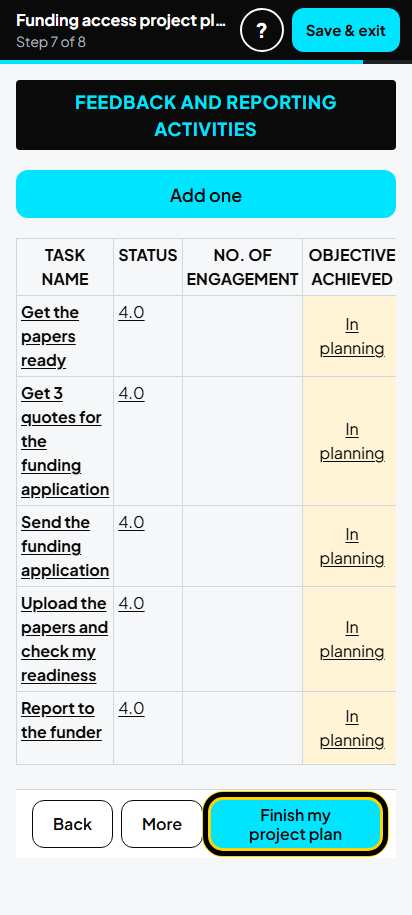

    Screenshot for step 63: Finish my project plan
  18. Step 64 of 73

    Your project plan is ready

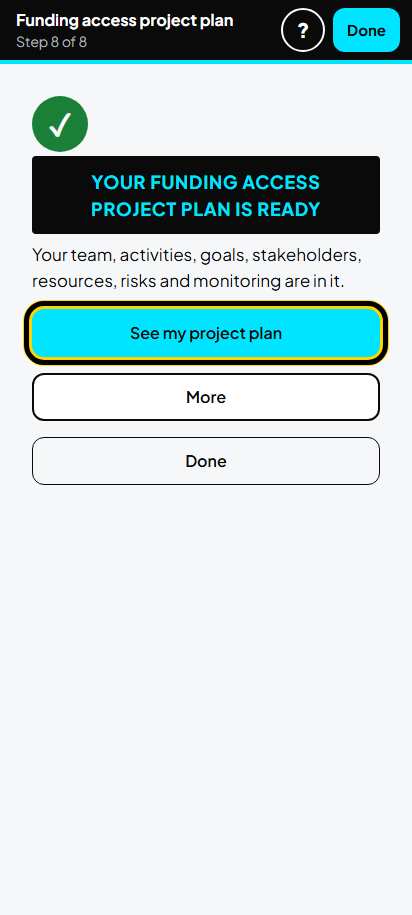

    This page says your project plan is ready. Tap See my project plan to read it. More has the download, the status report and the final report.

    Screenshot for step 64: Your project plan is ready
  19. Step 65 of 73

    See your project plan

    On your project home, tap See my project plan.

    Screenshot for step 65: See your project plan
  20. Step 66 of 73

    Your project plan on screen

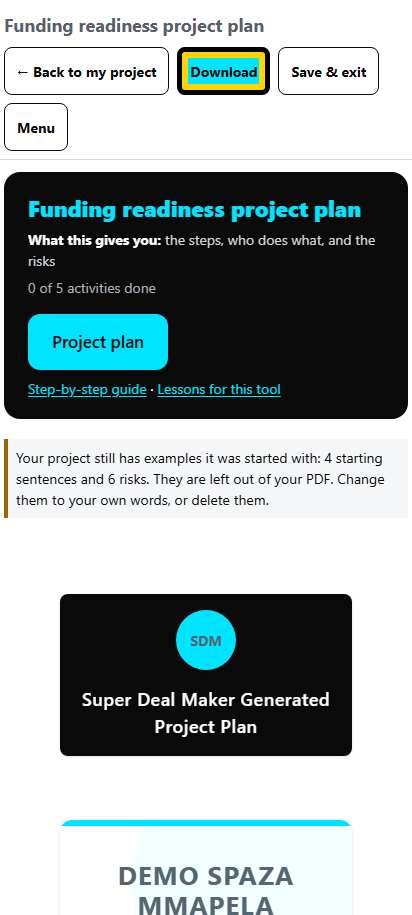

    Read it on your phone. Tap Download at the top to save the PDF, or Back to my project.

    Screenshot for step 66: Your project plan on screen
  21. Step 67 of 73

    Download the project plan

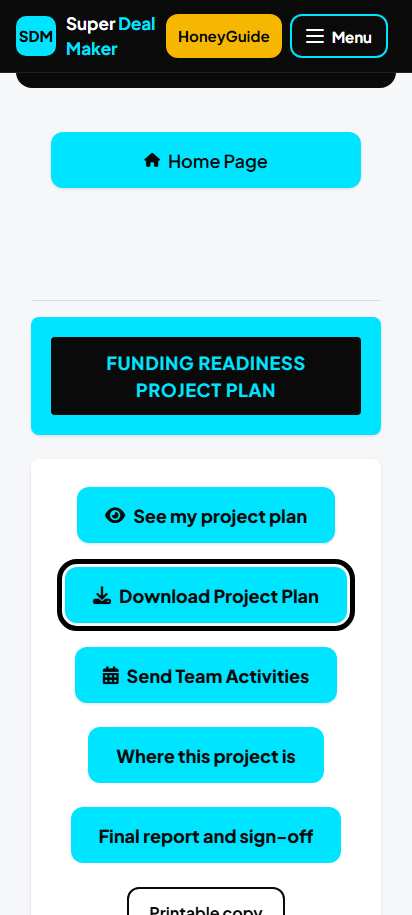

    On your project home you can also tap Download Project Plan.

    Screenshot for step 67: Download the project plan

Stop, carry on, and get help

  1. Step 68 of 73

    Stop for now

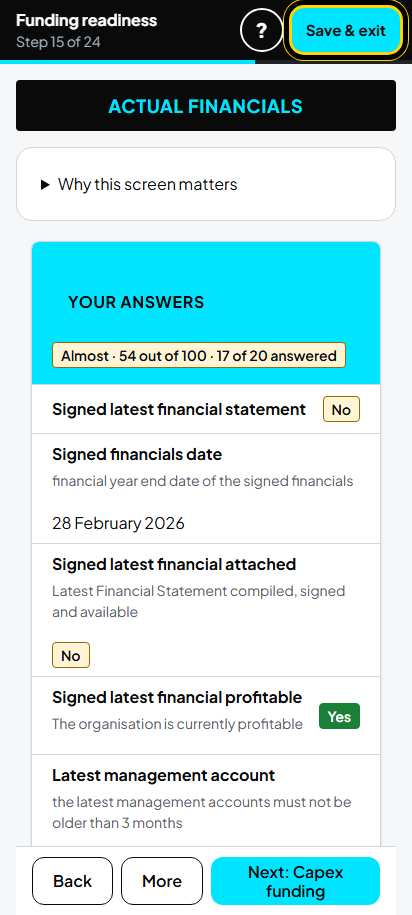

    Tap Save & exit at the top. First tap Save your answers so your last answers are saved.

    Screenshot for step 68: Stop for now
  2. Step 69 of 73

    Carry on later

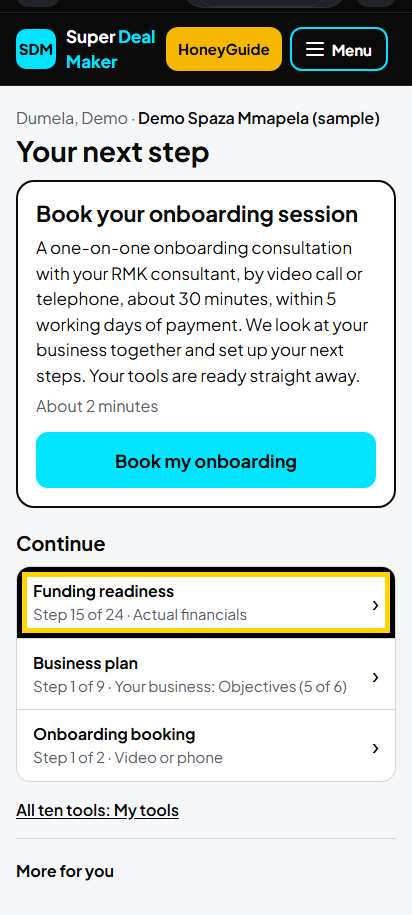

    On Home, under Continue, tap Funding readiness. It says where you stopped, for example "Step 15 of 24 · Actual financials".

    Screenshot for step 69: Carry on later
  3. Step 70 of 73

    Help for this screen

    Tap ? at the top of any screen.

    Screenshot for step 70: Help for this screen
  4. Step 71 of 73

    HoneyGuide

    HoneyGuide, the RMK assistant, opens over the screen and already knows which step you are on. Type your question, or tap Talk to a person. Tap X to close it.

    Screenshot for step 71: HoneyGuide
  5. Step 72 of 73

    Get help from a person

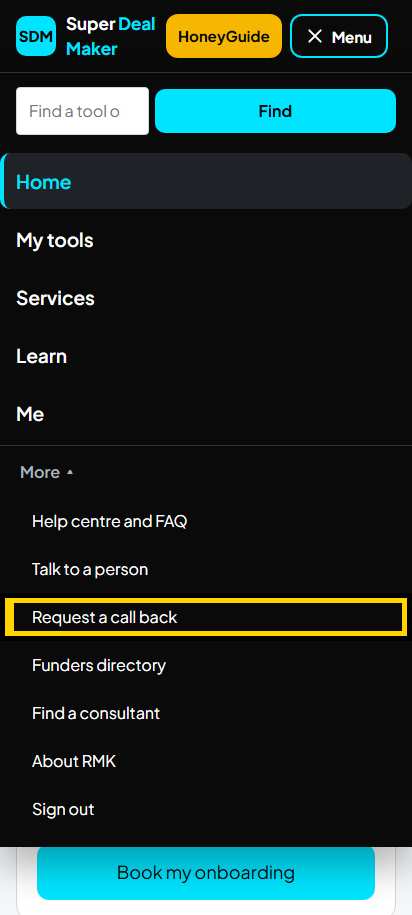

    Tap Menu, then More: Talk to a person (WhatsApp) or Request a call back. Many pages also have Stuck? Talk to a person and Request a call back at the bottom.

    Screenshot for step 72: Get help from a person
  6. Step 73 of 73

    Ask us to phone you

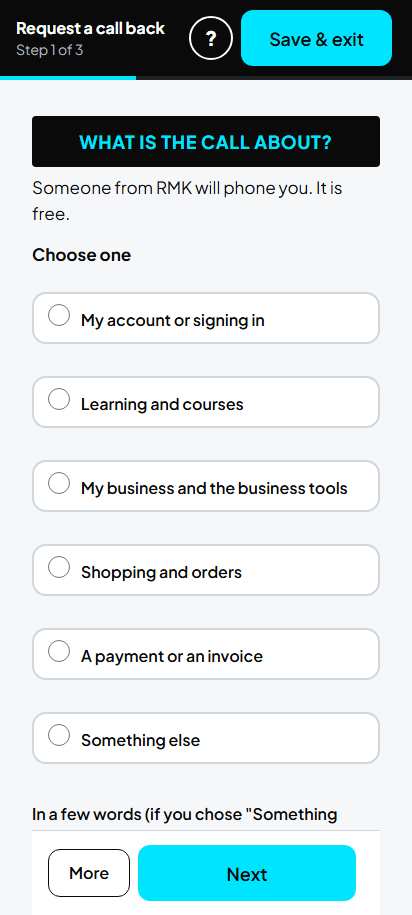

    Choose what the call is about, tap Next, and follow the 3 short steps. Someone from RMK will phone you. It is free.

    Screenshot for step 73: Ask us to phone you

Stop and carry on later

  • Tap **Save your answers** first, then **Save & exit** at the top of the screen.
  • Next time, on **Home** under **Continue** tap **Funding readiness**. Or open **Menu**, **My tools**, Funding readiness, and tap **Continue where you left off** or an area.
  • Your funding readiness page shows each area with "n of m answered": open the ones not yet answered.

Download your work

  • Funding readiness report: on your result page tap **More**, then **Download my report**. Or open the report and tap **Download Report** (Standard and up). About 4 seconds, 12 pages.
  • Guide for one screen: on that screen tap **Download the ... handbook (PDF)** (everybody).
  • Project plan: on your project home tap **Download Project Plan**, or **See my project plan** and then **Download** (Standard and up).
  • Free account: you see your score and report on screen; to download the report you see a note that it is part of Standard.
  • You can download up to 10 documents a day. After that a page says to come back tomorrow.

If something goes wrong

  • "Something went wrong on our side": tap **Go back**, check your last answers and save again. If it happens again, ask us to phone you.
  • Your answer is not in the list (for example a municipal licence or a start-up cost below R250 000): choose the closest answer and write the real one in the comment box.
  • A screen says "0 out of 100" although you answered: some screens count only when the document is uploaded. Read the line "Scored 0 until this is fixed" and upload that document.
  • A project risk will not save: choose the area, impact, likelihood, ranking and action, then tap Confirm.
  • An example project risk cannot be deleted: change it to fit your business instead.
  • A funding product says "Not open to you yet": it says what is missing. Fix that and your matches get better. A match is not a funder's decision.

Ask for help

  • Tap **?** at the top of any screen for help on that screen (HoneyGuide).
  • Tap **Menu**, then **More**: **Talk to a person** on WhatsApp, or **Request a call back** (free).
  • On many pages: **Stuck? Talk to a person** and **Request a call back**. On the full funding readiness page: **Ask us about any of these**.
  • With Standard: your RMK consultant helps you in the onboarding session and the monthly group session.

See the guides for the other tools

Need help?

Stuck? Ask HoneyGuide. It answers from RMK’s own guides and training material, and if it can’t help, it connects you to a person.
